The Schedule section of the Project Workspace is where the top deliverables and milestones for the project are tracked and managed.

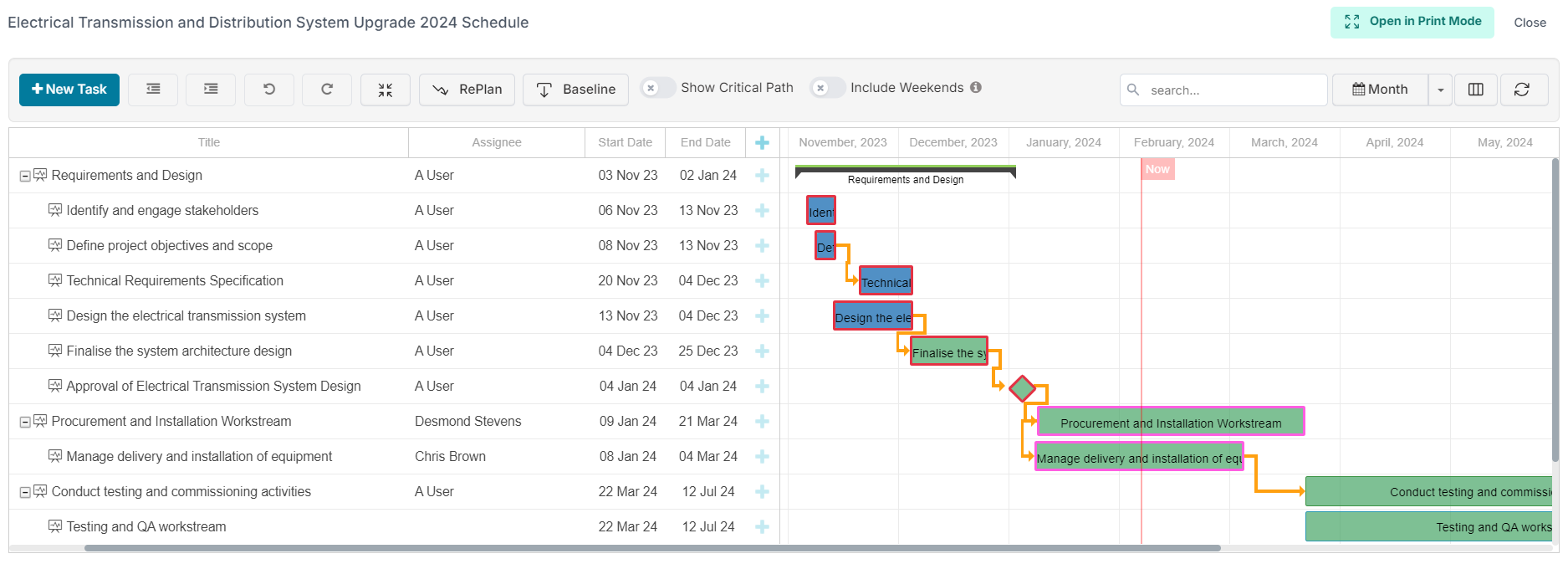

The schedule plan is shown on the Project Workspace, visually displaying the items that have been promoted from the Gantt chart for reporting - for the date range of the items listed. Navigate to the Project Schedule by either scrolling down on your Project Workspace, or by selecting Schedule from the left-hand navigation pane.
The schedule combines 3 pieces of delivery information:
- TIMELINE: The first entry on the schedule is the total timeline of the project. This entry is informed by the start and end dates for the project under the project settings.
- PHASES: Next come the methodology phases. These entries are informed by the phase dates set for the project under the project settings.
- GANTT: All the promoted schedule items from the project's Gantt chart.
The Project Schedule Toolbar
Click on Edit in Gantt View to see the full plan for the project and to manage and populate the schedule.
There are various options for populating a project schedule:
1. MANUALLY:
Add schedule entries through Fluid's User Interface (UI) by using New Task at the top left of the screen, or the icon on the schedule;
2. EXCEL UPLOAD:
Upload an Excel spreadsheet of schedule items using the Bulk Edit feature under Tools at the top right of the screen; OR
3. MS PROJECT FILE UPLOAD:
Import your MS Project Plan using .mpp, .mpt or .xml files, under Tools at the top right of the screen.

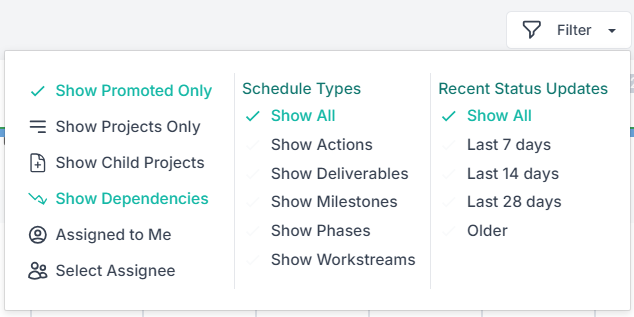

![]() | Click on the Project Schedule Filter to show schedule tasks assigned to you, with most Recent Status Updates or by Schedule Type. |
Gantt Chart Tool Bar

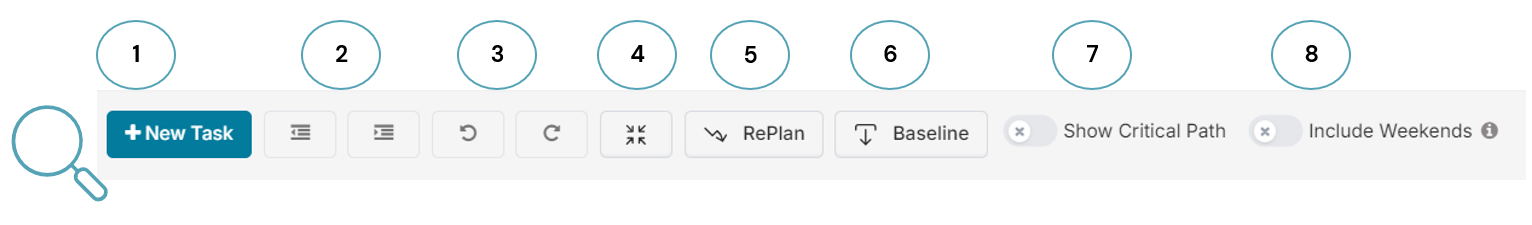

1. New Task to create a new Tier 1 Schedule Item. Click on ![]() 2. Indent and Outdent line items to create hierarchies. 3. Undo and Redo changes made. 4. Replan the schedule - recalculate the plan according to dependent (linked) tasks. 5. Show Critical Path toggle to YES to highlight all the items and relationships that lie on the shortest timeline in which the project can be completed. 6. Include Weekends to include/exclude weekend days (Saturday and Sunday) for a schedule item's duration. (Note: by default the Gantt schedule will be set to include weekends. The project manager can update the flag to turn off the Include Weekends option) | ||
8. Zoom the schedule display by day, week, month, quarter or year 9. Schedule Columns toggle to choose which columns to display. 10. Refresh the Gantt chart. Gantt Chart View | ||

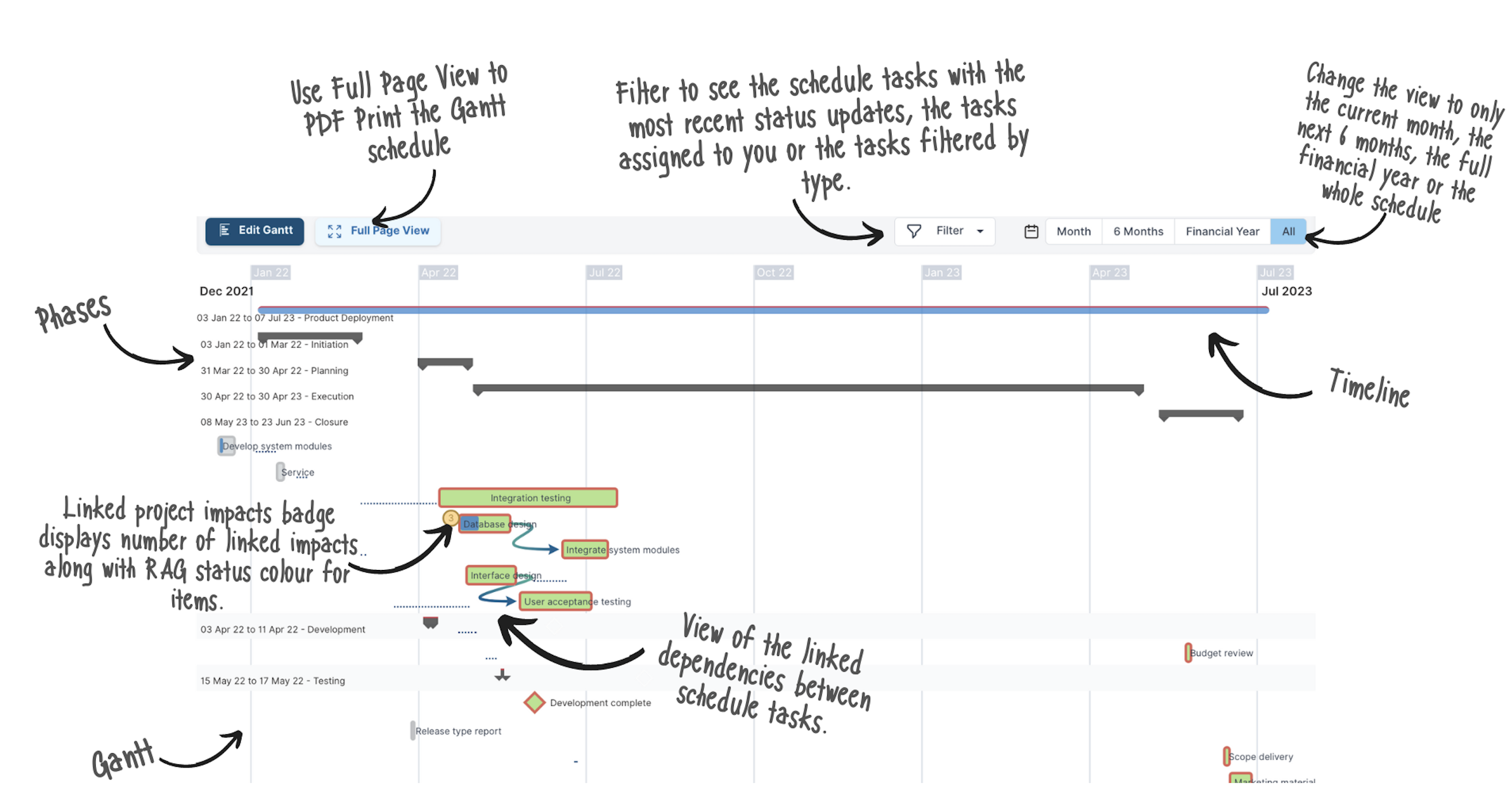

![]() | The left side of the Gantt view displays a list of the schedule items. Re-order line items by simply clicking on and dragging them up or down the list. At a glance you can see the following for each item:
| |
The intuitive drag-and-drop interface on the right side of the Gantt view allows you to:
| ![]() |
Understanding Task Dependencies
Dependencies are the relationships among tasks which determine the order in which activities need to be performed.
Fluid supports all four (4) types of task dependency relationships:
![]() | Finish-to-Start | Predecessor (Task #1) must finish before Successor (Task #2) can start. (i.e. Land must be bought before building can begin) |
![]() | Start to Start | Predecessor (Task #1) must start before Successor (Task #2) can start. (i.e. Excavating must start before foundations can be laid) |
![]() | Finish to Finish | Predecessor (Task #1) must finish before Successor (Task #2) can finish. (i.e. Plastering must be completed before painting can be completed) |
![]() | Start to Finish | Predecessor (Task #1) must start before Successor (Task #2) can finish. (i.e. Roof must start before interior painting can be completed) |
Tasks may have one or multiple preceding tasks and one or multiple succeeding tasks.
The most common dependency relationship is a finish-to-start relationship - the least common is the start-to-finish relationship.
Learn how to Update a Schedule Task here.
